Project

General

Profile

Gantt

Filters

Zoom in Zoom out « January | March »

months from Apply Clear

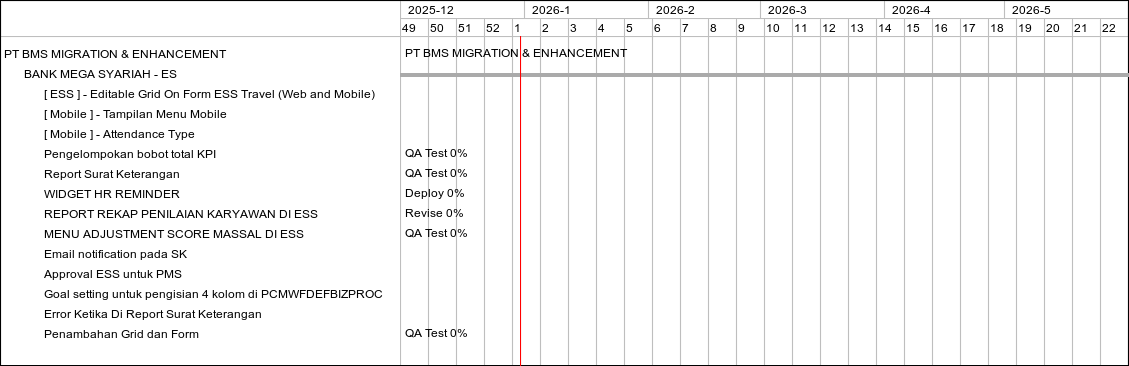

Feature #1404: [ ESS ] - Editable Grid On Form ESS Travel (Web and Mobile)
Feature #1405: [ Mobile ] - Tampilan Menu Mobile
Bug #1409: [ Mobile ] - Attendance Type
Support #3239: Pengelompokan bobot total KPI
Feature #3242: Report Surat Keterangan
Feature #3244: WIDGET HR REMINDER
Feature #3249: REPORT REKAP PENILAIAN KARYAWAN DI ESS
Feature #3252: MENU ADJUSTMENT SCORE MASSAL DI ESS
Bug #3297: Email notification pada SK
Bug #3357: Approval ESS untuk PMS
Bug #3372: Goal setting untuk pengisian 4 kolom di PCMWFDEFBIZPROC
Bug #3405: Error Ketika Di Report Surat Keterangan
Feature #3410: Penambahan Grid dan Form

Status

QA Test
Revise
Revise
QA Test
QA Test
Deploy
Revise
QA Test
Deploy
QA Test
QA Test
QA Test
QA Test

Priority

Urgent
Urgent
High
Normal
Normal
High
High
Urgent
Normal
Normal
Normal
High
Normal

Updated

10/07/2022 04:51 PM
11/15/2022 09:15 AM
10/31/2022 10:30 AM
02/19/2025 05:50 PM
05/02/2025 02:56 PM
01/31/2025 04:44 PM
03/21/2025 08:29 AM
04/09/2025 08:47 AM
01/31/2025 04:43 PM
03/03/2025 04:33 PM
02/17/2025 09:34 AM
03/12/2025 07:37 PM
02/19/2025 10:02 AM


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
PT BMS MIGRATION & ENHANCEMENT

BANK MEGA SYARIAH - ES
QA Test 0%
QA Test 0%
Deploy 0%
Revise 0%
QA Test 0%
QA Test 0%


Also available in: PDF PNG
