Project

General

Profile

Gantt

Filters

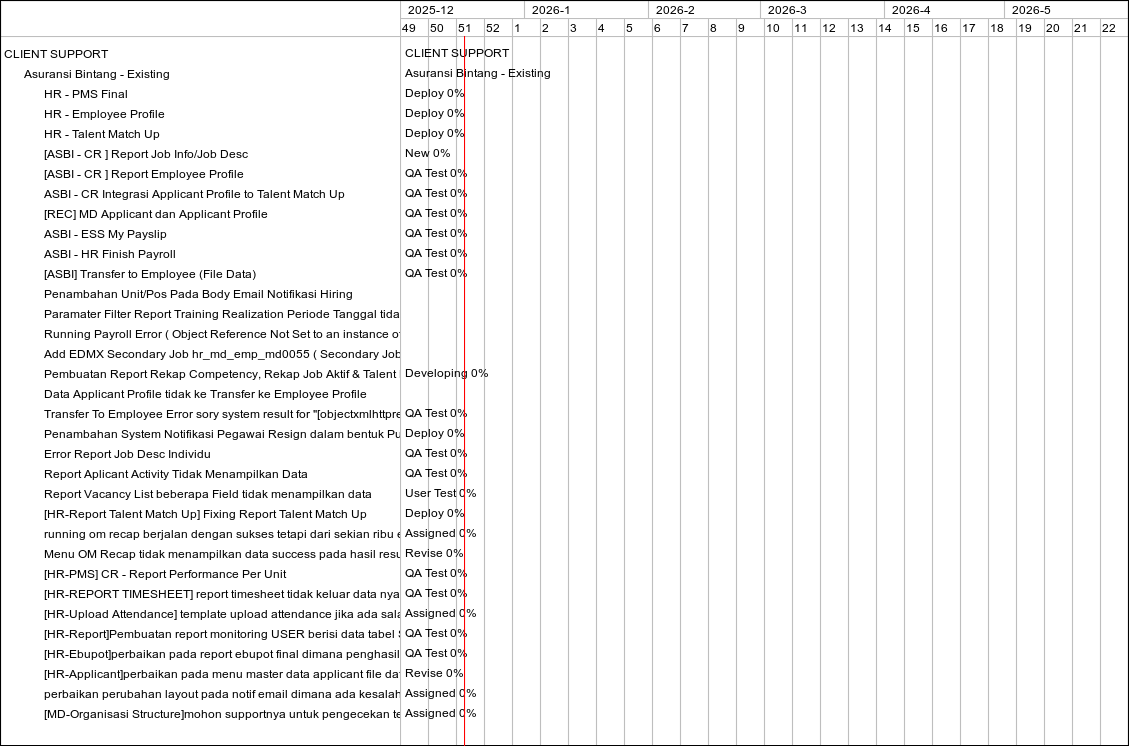

Zoom in Zoom out « January | March »

months from Apply Clear

Bug #64: HR - PMS Final
Bug #65: HR - Employee Profile
Bug #66: HR - Talent Match Up
Feature #281: [ASBI - CR ] Report Job Info/Job Desc
Feature #326: [ASBI - CR ] Report Employee Profile
Feature #342: ASBI - CR Integrasi Applicant Profile to Talent Match Up
Bug #405: [REC] MD Applicant dan Applicant Profile
Bug #415: ASBI - ESS My Payslip
Bug #417: ASBI - HR Finish Payroll
Bug #448: [ASBI] Transfer to Employee (File Data)
Feature #553: Penambahan Unit/Pos Pada Body Email Notifikasi Hiring
Bug #723: Paramater Filter Report Training Realization Periode Tanggal tidak aktif
Bug #790: Running Payroll Error ( Object Reference Not Set to an instance of an object )
Feature #823: Add EDMX Secondary Job hr_md_emp_md0055 ( Secondary Job Lebih dari satu di startdate & enddate yang sma)
Feature #849: Pembuatan Report Rekap Competency, Rekap Job Aktif & Talent Match Up
Bug #947: Data Applicant Profile tidak ke Transfer ke Employee Profile
Bug #1021: Transfer To Employee Error sory system result for "[objectxmlhttprequest]-error, please contact system administrator "
Feature #1037: Penambahan System Notifikasi Pegawai Resign dalam bentuk Push Mail
Bug #1040: Error Report Job Desc Individu
Bug #1083: Report Aplicant Activity Tidak Menampilkan Data
Bug #1084: Report Vacancy List beberapa Field tidak menampilkan data
Support #1566: [HR-Report Talent Match Up] Fixing Report Talent Match Up
Bug #1911: running om recap berjalan dengan sukses tetapi dari sekian ribu employee, data nya ada beberapa employee yang tidak terupdate untuk ds1 dan s2 nya.
Bug #1918: Menu OM Recap tidak menampilkan data success pada hasil result nya
Feature #2283: [HR-PMS] CR - Report Performance Per Unit
Bug #2485: [HR-REPORT TIMESHEET] report timesheet tidak keluar data nya jika personal working schedule nya kosong.
Bug #2582: [HR-Upload Attendance] template upload attendance jika ada salah satu time start atau time end kosong maka akan terjadi error
Feature #3226: [HR-Report]Pembuatan report monitoring USER berisi data tabel SUSER
Bug #3406: [HR-Ebupot]perbaikan pada report ebupot final dimana penghasilan netto mas pajak sebelum nya itu tidak sesuai jika orang tersebut mutasi.
Bug #3444: [HR-Applicant]perbaikan pada menu master data applicant file data dimana pada saat upload file data itu stuck loading dan tidak ada respon.
Bug #3638: perbaikan perubahan layout pada notif email dimana ada kesalahan pada kolom notifikasi email resign
Bug #3712: [MD-Organisasi Structure]mohon supportnya untuk pengecekan terkait relasi di organisasi dimana dibawah agnecy sales head (berlin citra siwi) kosong tidak ada anak buahnya, sedangkan di organisasi struktur ada anak buah nya (helen pranitasari) employeeid 0
Bug #4103: [HR-Statistic]tuning pada menu run statistic karena ada query yang tetep berjalan di db walau aplikasi nya sukses. mengakibatkan pada submit ess menjadi loading muter2.

Status

Deploy
Deploy
Deploy
New
QA Test
QA Test
QA Test
QA Test
QA Test
QA Test
QA Test
Deploy
Deploy
QA Test
Developing
New
QA Test
Deploy
QA Test
QA Test
User Test
Deploy
Assigned
Revise
QA Test
QA Test
Assigned
QA Test
QA Test
Revise
Assigned
Assigned
Assigned

Priority

High
High
High
High
Urgent
High
High
Urgent
Urgent
High
Normal
Urgent
High
Normal
High
High
Immediate
High
Urgent
High
High
Normal
Urgent
Normal
Normal
High
Normal
High
Normal
High
High
High
Normal

Updated

04/07/2021 10:11 AM
04/26/2021 09:57 AM
12/02/2020 03:13 PM
06/04/2021 09:39 AM
05/20/2021 04:50 PM
06/16/2021 09:24 AM
06/22/2021 04:19 PM
08/20/2021 10:37 AM
08/20/2021 10:35 AM
10/11/2021 11:44 AM
11/18/2021 03:22 PM
01/05/2022 06:39 PM
01/26/2022 04:59 PM
02/04/2022 10:23 AM
02/22/2022 02:11 PM
03/08/2022 09:55 AM
04/13/2022 04:54 PM
05/24/2022 04:10 PM
04/12/2022 11:37 AM
04/22/2022 03:09 PM
04/21/2022 04:18 PM
09/12/2022 10:17 AM
10/05/2023 05:38 PM
01/11/2023 06:51 PM
07/07/2023 04:23 PM
01/15/2024 02:16 PM
04/04/2024 09:23 AM
11/26/2024 12:00 PM
02/14/2025 04:49 PM
02/27/2025 02:48 PM
05/26/2025 04:32 PM
07/15/2025 04:14 PM
12/19/2025 02:04 PM


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
CLIENT SUPPORT

Asuransi Bintang - Existing
Deploy 0%
Deploy 0%
Deploy 0%
New 0%
QA Test 0%
QA Test 0%
QA Test 0%
QA Test 0%
QA Test 0%
QA Test 0%
Developing 0%
QA Test 0%
Deploy 0%
QA Test 0%
QA Test 0%
User Test 0%
Deploy 0%
Assigned 0%
Revise 0%
QA Test 0%
QA Test 0%
Assigned 0%
QA Test 0%


QA Test 0%
Bug #3406: [HR-Ebupot]perbaikan pada report ebupot final dimana penghasilan netto mas pajak sebelum nya itu tidak sesuai jika orang tersebut mutasi.

Project: Asuransi Bintang - Existing
Status: QA Test
Start date: 02/06/2025
Due date: 02/11/2025
Assignee: Muhammad Bintar
Priority: Normal


Revise 0%
Bug #3444: [HR-Applicant]perbaikan pada menu master data applicant file data dimana pada saat upload file data itu stuck loading dan tidak ada respon.

Project: Asuransi Bintang - Existing
Status: Revise
Start date: 02/21/2025
Due date: 02/25/2025
Assignee: Muhammad Bintar
Priority: High


Assigned 0%
Bug #3638: perbaikan perubahan layout pada notif email dimana ada kesalahan pada kolom notifikasi email resign

Project: Asuransi Bintang - Existing
Status: Assigned
Start date: 05/26/2025
Due date: 05/30/2025
Assignee: shofwan shiddiq
Priority: High


Assigned 0%
Bug #3712: [MD-Organisasi Structure]mohon supportnya untuk pengecekan terkait relasi di organisasi dimana dibawah agnecy sales head (berlin citra siwi) kosong tidak ada anak buahnya, sedangkan di organisasi struktur ada anak buah nya (helen pranitasari) employeeid 0

Project: Asuransi Bintang - Existing
Status: Assigned
Start date: 07/07/2025
Due date: 07/14/2025
Assignee: Mohammad Daud
Priority: High
Assigned 0%

Also available in: PDF PNG
